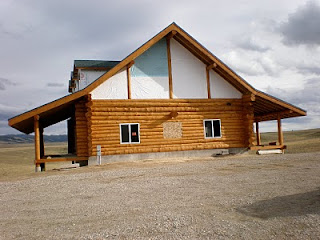

Tuesday, August 31, 2010
House dried in 100%, Aug 31, 2010
Monday, August 30, 2010
Finished installing windows available, Aug 30, 2010
Today I finished installing all the windows I have purchased so far. There are 4 windows in the loft and 2 windows on the main floor that are not available at this time. These are the windows on the west side of the house in the family room. Below are the windows on the North side of the house. I am in the process of framing in the center window. I will sheet it over with OSB for the winter. When I get the window next year, I can install it very quickly. I will finish this window tomorrow. There is one other window I will frame out and sheet over tomorrow.
will do temporary frames on them and sheet them over with OSB for the winter.
I will be spending the next few days wrapping up loose ends. I plan to head home by September 6th at the latest.
Friday, August 27, 2010
View of loft from the main floor, Aug 27, 2010
Installing windows And doors, Aug 27, 2010
When I bought the windows, they only had 2 - 4' X 4' windows, which is just what I needed for the main floor. The 4 - 4' X 4' windows that I sheeted over in the gables will have to be completed next year. The dealer said they would not be in until the end of the year.
I also need a 4' X 3' window, and a 4' X 3.5' window for the main floor. They were out of stock on these also, so I will frame these windows out with 2 X 6s and sheet them over with OSB for the winter. Next year I will install them when I install the windows in the gables.
I will probably be framing out the last 3 doors on the main floor and sheeting them over with OSB for the winter. At this point, the house will be completely dried in.
Wednesday, August 25, 2010
End gables sheeted & wrapped, Aug 25, 2010
Tomorrow I will finish staining the last half of the ridgepole, the last half of the west side purlin, and three of the upright logs supporting the roof system. With these completed, the only staining left on the house is the 2 inch strip on the underside of the facia boards. This has to be completed before I install the soffit boards. Since I won't install any soffit boards this year, it can wait for next year.
Once I have completed the inside staining I will dismantle all the scaffolding, load them on two trailers, and return them to Al Anderson and Paul Talon.
I have a load of 15 sheets of OSB being delivered tomorrow to sheet over the main floor doors and windows. I will cut them so I can use them on the garage roof next year. I will send back 14 sheets of 7/16" OSB, 6 - 24' TGIs and 8 -2 X 6 X 16' with the driver for credit. This will clean up all my building supplies on site for the year.
I have one 3' exterior door that I purchased last year that I will install on the main floor on the north east corner of the house. This will give me access to the house, yet allow it to be locked up for the winter.
Monday, August 23, 2010
Finished framing end gables, Aug 23, 2010
After the gables are sheeted the next step is to cut the windows and doors on the main floor to their final size and frame them in. I may just install one door on the main floor, and sheet over the other doors and windows for the winter.
Saturday, August 21, 2010
Framing 75% complete, Aug 21, 2010
The wind was blowing so hard today from the south that my cap kept blowing off my head. Tony was staining the ridgepole and had to stop because of the wind.
Thursday, August 19, 2010
Framing end gables, Aug 19, 2010
Yesterday I also installed the last two beams in the basement. They support the logs that run from the main floor all the way to the roof system.
Wednesday, August 18, 2010
Finished shingling, Aug 18, 2010
Framing the end gables requires two people as we will do a lot of it using the lift.
Saturday, August 14, 2010
When I planned the garage slab, I did not remember that the sill logs should be at least 18" above ground level to protect the logs from water splashing and causing decay. Yesterday we poured a 20" wall around the garage, leaving the openings for the two garage doors and the side access door. I have 14 logs peeled for the garage right now, but I will not start putting the logs on the wall until next year.

Wednesday, August 11, 2010
Shingling has begun on both sides, Aug 11, 2010
All facia and drip edge has been installed. We were rained out again today at 3:00 PM. It feels like Florida where it would rain every afternoon.
Once the end gables are framed in, we can install the soffits on both ends of the house and over the deck on both sides.
Tuesday, August 10, 2010
Started Shingling, Aug 6, 2010
The east side of the house now has felt installed up to the bottom of the dormers. All valley metal has been installed where the deck roof meets the upper roof on both sides, and above the dormers. Once the felt is installed on the east side to the peak, we can install the rest of the drip edge and begin shingling.
My plan is to have the roof completely shingled by the end of this week so we can begin framing in the end gables next week.
Wednesday, August 4, 2010
Installing facia, Aug 4, 2010
Tomorrow we should be able to start shingling the roof. Installing the facia is taking a lot longer than I thought it would. We also have to install facia on all three dormer roofs.
Tuesday, August 3, 2010
Finished dormers, Aug 3, 2010
On Sunday, my cousin Jim and I trimmed the top wall logs, purlins and ridgepole to length (flush with the outer TGIs) and stained the ends.
Today I picked up the cedar boards for the dormer roofs (1" X 8") and stained all of them. We also picked up the drip edge today. The drip edge is a dark green. Tomorrow we will cut the edges of the roof sheeting flush and install nailers on the end TGIs for the facia, begin installing facia and drip edge.
Thursday, July 29, 2010
Roof sheeting complete, July 29, 2010
We started building the dormers today. We have the framework in place. Tomorrow we will build a roof on each dormer, sheet the three roofs, then sheet the dormer exterior walls. Once the dormer walls are sheeted, we will wrap them with Tyvek.
The next step is to install the cedar facia, (Which was finally delivered today) install the valley tin where the house roof meeting the deck roof, install the drip edge, install the felt and weather guard, then get ready to shingle.
Wednesday, July 28, 2010
Sheeting close to completion, July 28, 2010
Today we finished sheeting the west side of the roof. We cut the tails of the rafters/TGIs plumb over the deck and faced it with another TGI. The pitch of the roof is 9 X 12 so it is very hard to climb it with sheets of OSB ( 5/8" sheeting) in our hands. Below is the east side.
Tomorrow we will install the last strip of sheeting at the top, chalk line the tails over the deck, cut them plumb and face this side with TGIs. Then we can install the last strip at the bottom. We will then begin building the dormers and installing the facia all around the house. We will be using 1 X 12 cedar boards, then 1 X 4 cedar boards at the top to give it a nicer look.
Once we get the facia completely installed, we need to trim all roof sheeting flush with the outside of the 1 X 4s, and install the drip edge around the entire roof. (We need to stain the cedar boards before we install the drip edge.)
Monday, July 26, 2010
The sheeting has begun, July 26, 2010
Once we get all the roof sheeting completed, we will remove all bracing from the roof system in the loft area.
Friday, July 23, 2010
Rafters close to completion, July 22, 2010
Tuesday, July 20, 2010

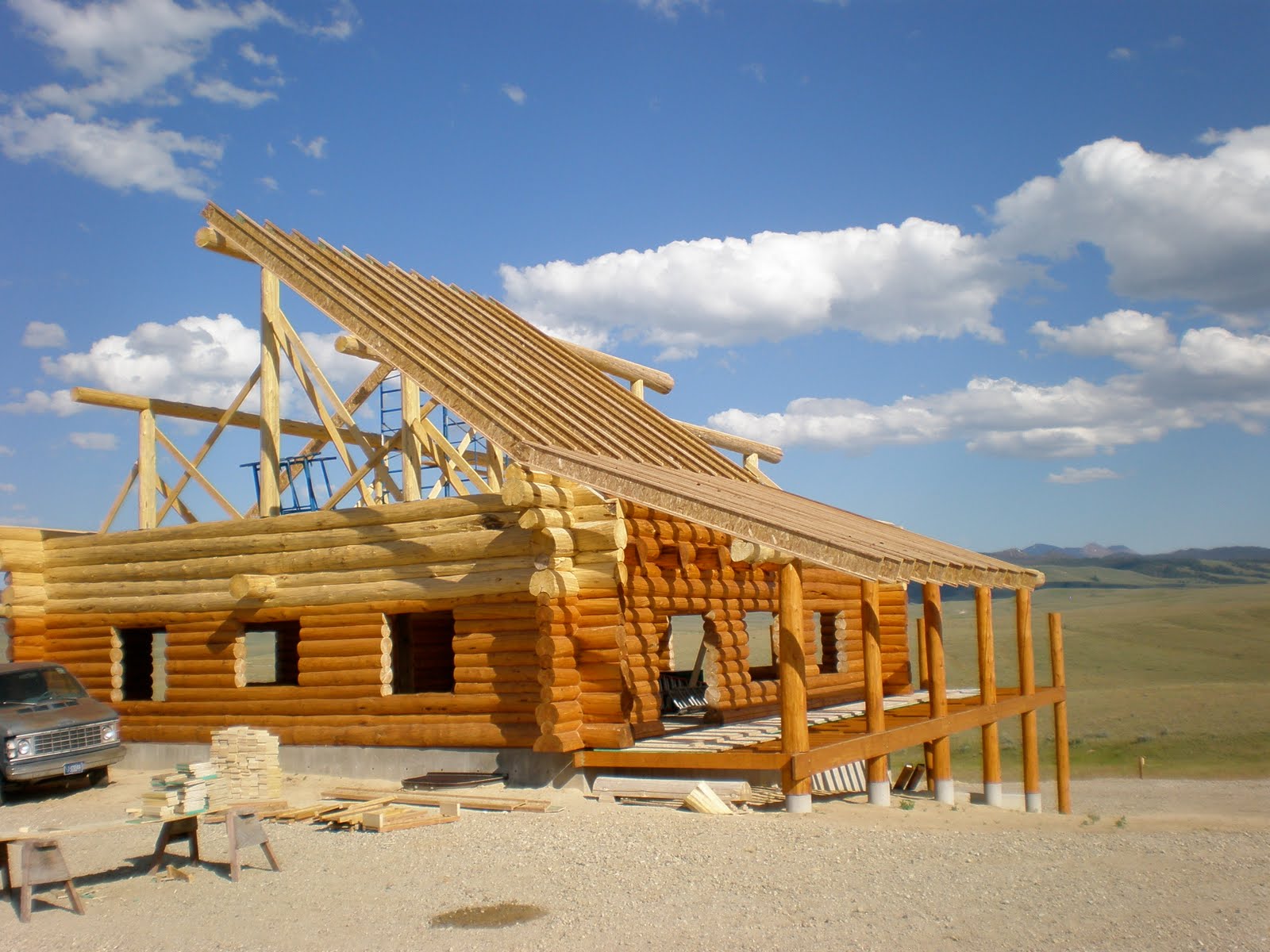

The roof begins, July 20, 2010
Tony showed up again today to stain the exterior logs. He finished the right side on Saturday, and the left side today.
I also got up close and personal with a trim saw today. My thumb should heal fully in a week or so. Not such good news for the glove I was wearing.
Thursday, July 15, 2010
Log work completed, July 15, 2010
Today we finished all the log work on the house. We will begin installing the roof on Monday. I ordered all the material today to be delivered early Monday morning. I also talked to the stove people to see what we needed for roof attachments for the wood stove. They will be out as soon as we get the rafters installed to take measurements and tell us what we need for installing the pipes to code.
Below, you can see the last support logs installed on the main floor. The log by the family room is a very heavy log. We chose it to match the size of the log above it in the loft.
Tomorrow, I will finish installing the last loft floor board, which needs to be scribed in and cut. I will then begin staining logs. I have a guy, Tony, who stained the logs last year coming on Saturday. He does an amazing job with stain and caulking. We also chose the siding to be installed on both gable ends, the dormers and the basement outside wall.

Wednesday, July 14, 2010
First Deck log completed, July 14, 2010
Tomorrow we will install the deck log on the other side of the house and install the last two vertical support logs on the main floor. I have to install two more 6 X 6's in the basement as soon as the roof is on the house. These finish the support for the purlins right down to the basement floor. We poured an extra pad of cement under the basement floor to support these better. After tomorrow, I will be ready to install the roof and shingles, and frame in the dormers and end gables.
Sunday, July 11, 2010
Roof System Installation, July 11, 2010
Wednesday, July 7, 2010
Installing loft floor, July 7, 2010
Sunday, July 4, 2010
July 4th, a day off!
Wall logs completed, July 2, 2010
The end logs have been flattened on top to accept the uprights that hold the ridgepole and the purlins, and to give us flat surfaces to frame in the gables. I also flattened two sides of the ridgepole on Saturday. This allows the TGI's (rafters) to be secured in a uniform manner. Monday we will flatten one side of each purlin, and one side of each deck log. The deck logs rest on the top of the tallest deck posts and will support the roof over the deck. We will then prepare the uprights that will be placed on the end walls to support the ridgepole and the two purlins on both ends. There will also be uprights in the center of the ridgepole and each purlin. These will be supported by other uprights right down to the basement floor.
The plan is to have all the roof system parts completed by this coming wednesday and get a crane in on Friday to lift everything into place. At this point, the log work for the house will be complete, and I can begin installing the roof, the soffits, and frame in the end gables.
The plan is to install three dormers on the roof. One dormer will be in each upstairs bedroom, and one will be in the open area between the two bedrooms. This may end up as a bathroom in the loft at some point.
I also plan to install the loft subfloor this week to give us a working platform when we install the roof system.
Thursday, July 1, 2010
14th round completed, July 1, 2010
Tuesday, June 29, 2010
Half of 14th round completed, June 29, 2010
Monday, June 28, 2010
Round 13 completed, June 28, 2010
Wednesday, June 23, 2010
Loft logs installed. June 23, 2010
Friday, June 18, 2010

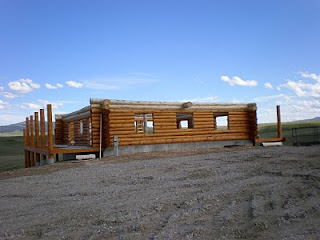

12th round completed, June 18, 2010
Thursday, June 17, 2010
Loft main beam and support posts, June 17, 2010
Tuesday, June 15, 2010
11th round completed. June 14, 2010
Monday, June 7, 2010
First log installed in 2010, June 7
Tuesday, April 13, 2010
Montana 2010 - Apr 13, 2010
In 6 weeks I will be back in Montana to complete the Log House I started in 2009. I am looking forward to the next phase of the building process. I will be installing one more round of logs, then I will begin installing the loft logs and the upright supports on the main floor of the house. I will try to find some logs that have character for these upright positions, as they will be visible after the building is complete. I had my cousin, Jim Hendrickson check the building out several times during the past winter and it sounds like everything is doing very well. A client of Jim's looked at our basement plan a month ago and liked it so well, Jim built an exact duplicate for them, right down to the retaining walls, for their home in Ramsey, MT.
